Page 50 - Customize-Project-Plan-by-tailoring-Smartsheet
P. 50

Customize your Project Plan
                                                                                                            
                                                                               by tailoring Smartsheet

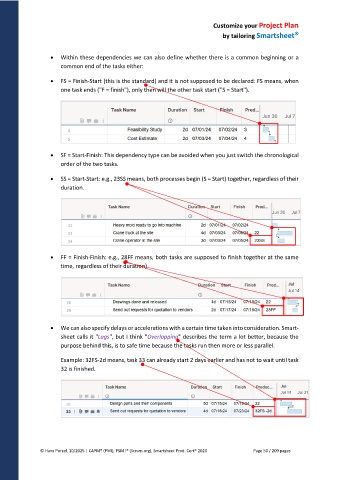

                     Within these dependencies we can also define whether there is a common beginning or a
                      common end of the tasks either:

                     FS = Finish-Start (this is the standard) and it is not supposed to be declared: FS means, when
                      one task ends ("F = finish"), only then will the other task start ("S = Start").












                     SF = Start-Finish: This dependency type can be avoided when you just switch the chronological
                      order of the two tasks.


                     SS = Start-Start: e.g., 23SS means, both processes begin (S = Start) together, regardless of their
                      duration.












                     FF = Finish-Finish: e.g., 28FF means, both tasks are supposed to finish together at the same
                      time, regardless of their duration)










                     We can also specify delays or accelerations with a certain time taken into consideration. Smart-
                      sheet calls it "Lags", but I think "Overlapping" describes the term a lot better, because the
                      purpose behind this, is to safe time because the tasks run then more or less parallel.

                      Example: 32FS-2d means, task 33 can already start 2 days earlier and has not to wait until task
                      32 is finished.














               © Hans Porzel, 10/2025 | CAPM® (PMI), PSM I® (Scrum.org), Smartsheet Prod. Cert® 2020                                             Page 50 / 209 pages
